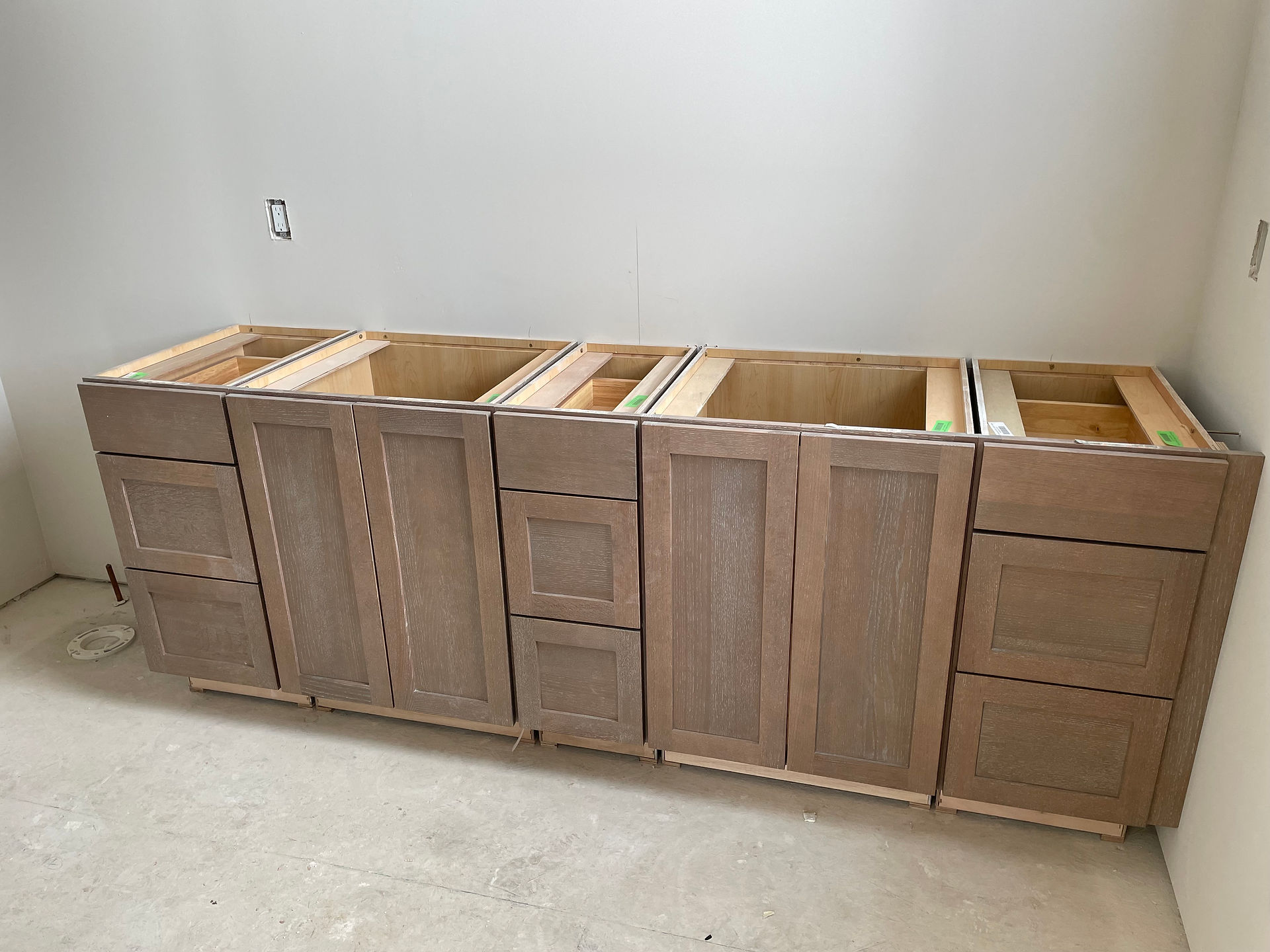

Following a shipping delay, the bathroom tile has finally arrived and crews are working to complete the bathrooms in Building G. Once complete, the electricians will install light fixtures throughout Units 119, 121, and 123. Boilers are being installed in Building E and the drywall crews have completed the texturing. Painters will begin work next week to allow for the trim crews to follow. In Building A, all insulation is in place and passed inspected, and the drywall crew was able to begin work on Unit 105. Exteriors continue to progress with the final delivery of siding material on site.
